Duas associações de municípios defendem a Ferrovia na consulta pública, e nenhuma delas fala pela Serra Catarinense — Insubornavel

Two municipal associations advocate for the railway in the public consultation, and neither speaks for the Catarinense Highlands.

উৎস: Insubornavel
লেখক Benito Juarez24/08/2026 às 14:47308 দর্শন
Capa da minuta de edital da Audiência Pública n.º 11/2026, a concorrência internacional que leiloará os três corredores da Malha Sul; dentro do Corredor Mercosul corre o trecho de 292,76 km entre Mafra e Lages.
Capa da minuta de edital da Audiência Pública n.º 11/2026, a concorrência internacional que leiloará os três corredores da Malha Sul; dentro do Corredor Mercosul corre o trecho de 292,76 km entre Mafra e Lages.
Reprodução: Audiência Pública n.º 11/2026, minuta de edital, documento oficial em consulta pública; captura do Insubornável. / ANTT

The National Agency of Land Transport - ANTT, extended until 11:59 PM on September 30, 2026, the deadline for contributions to Public Hearing No. 11/2026, which sets the tender and contract for the South Mesh for the next thirty years.

The National Land Transport Agency - ANTT has extended until 11:59 PM on September 30, 2026, the deadline for contributions to Public Hearing No. 11/2026, which sets the tender and contract for the South Grid for the next thirty years.The previous two parts of this series dealt with documents: the first showed that the section is on the concession map but not in the works plan; the second, the political and economic context.

This, the third part, will analyze the technical aspects and the potential impacts of the proposed section.The technical analysis reveals a series of inconsistencies and potential risks.The environmental impact study raises concerns about the preservation of biodiversity and the potential disruption of local communities.The economic feasibility study presents challenges in terms of investment and return on investment.He read the contract minute clause by clause and showed that the future concessionaire will have the duty to preserve the track and no deadline to put a train into operation on it. This concerns who went to the consultation asking for what, and who did not.

What is at stake
The public consultation is the only formal moment when the city hall, council, university, and civil society manage to insert, in the tender and contract, a specific obligation for a section: inspection, deadline, work value, safeguard against return. What is not requested by September 30 will not be in the text that the Agency will send to the Union Court of Accounts - TCU. Investigation of the Unyielding on the whole of the published contributions, with the documents inpublic archive.

Who went to the consultation, and about which part of the line?

The platform does not have a specific field for the author's name, so identification comes from the text, the signature, and the attachments of each piece. In the 180 contributions, the proposers are grouped into five blocks.

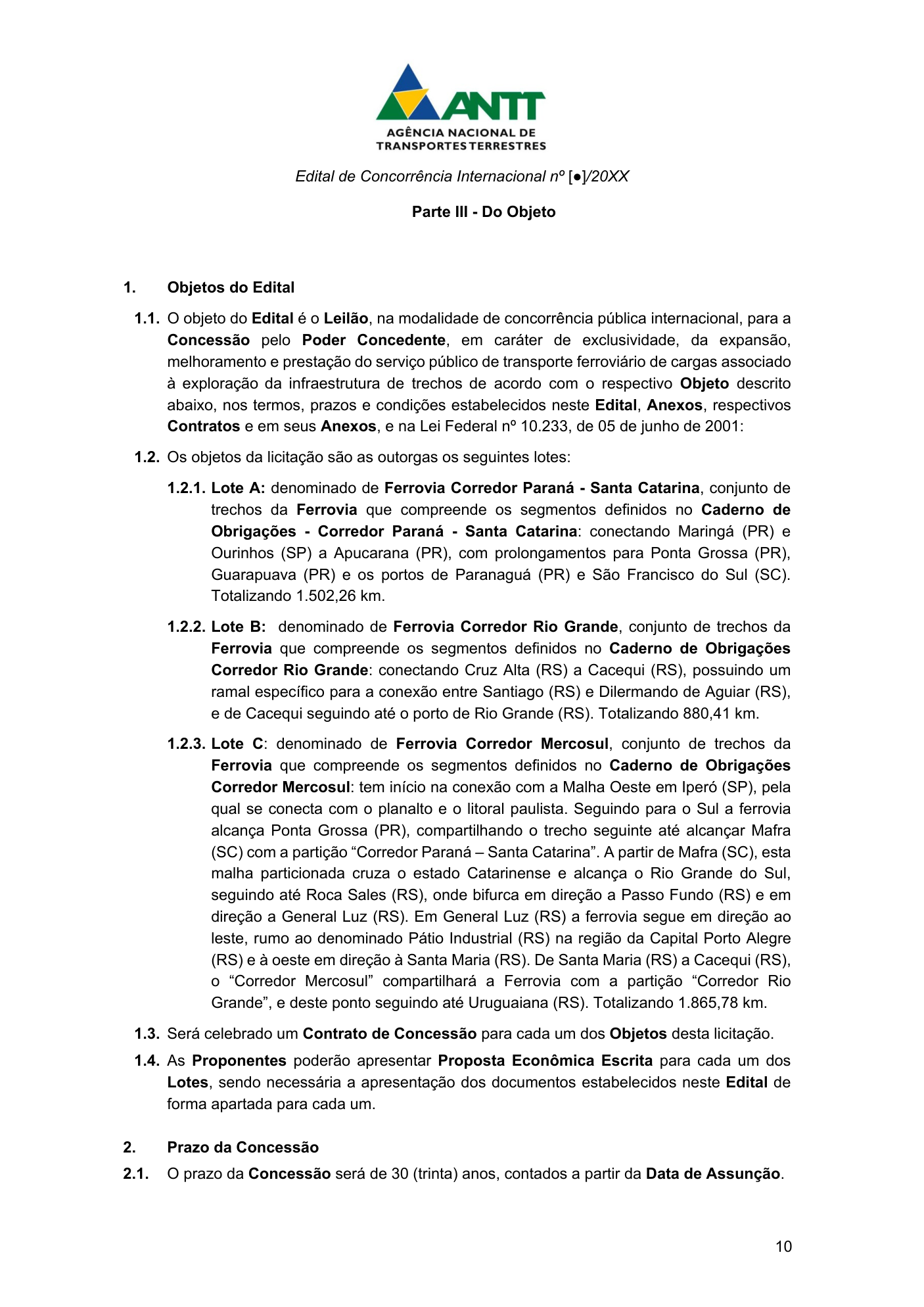

Página 10 da minuta de edital da ANTT, com o item 1.2.3 descrevendo o Lote C — Corredor Mercosul a partir de Mafra (SC)
This is the disputed lot: the Mercosul Corridor starts "from Mafra (SC)" and reaches Roca Sales (RS), with the 292.76 km section between them running through Lages.
Reproduction: ANTT — Public Hearing No. 11/2026, official document available for public consultation (Bern Article 2(4)); capture from Insubornável, August 7, 2026.

Industry and agriculture federations arrived with technical teams and numbered letters: the Federation of Industries of the State of Paraná — FIEP submitted nine contributions under Letter No. 28, August 6, 2026; the Federation of Industries of the State of Rio Grande do Sul — FIERGS and the Federation of Agriculture of Rio Grande do Sul — FARSUL opposed the fragmentation of the network; the Federation of Cooperatives of Paraná — FECOOPAR accepts all three lots as long as interoperability is guaranteed; and the Federation of Industries of the State of Santa Catarina — FIESC, which hosted the session in Florianópolis, submitted a document. The railway sector was represented by the National Association of Cargo Transport Users — ANUT, with three contributions for the block sale auction, by the National Association of Railway Transporters — ANTF, by Wabtec and GBMX manufacturers, by ABIFER with SIMEFRE, and by Terlogs. The Federal Public Ministry — MPF intervened twice on behalf of the Coordinated Action for the South Network, once regarding populations living in the right-of-way.

The state of Santa Catarina's representation was focused on the coastline and the north, not the plateau: the state government requested the Corupá Mountains and Babitonga Bay; the state of Paraná submitted approximately twelve draft proposals; the City of Curitiba intervened at least three times, with a study from the Urban Research and Planning Institute of Curitiba — IPPUC, advocating for the railway contour as an mandatory work. Among municipal associations, four from the Northeast and Northern Plateau — AMUNESC, AMPLANORTE, AMVALI, and the CIMU consortium — signed Circular Letter No. 7/2026, representing 26 municipalities and approximately 1.6 million inhabitants, requesting regional passenger transport studies on the EF-485, the coastal axis between São Francisco do Sul and Mafra, under the Federal Law No. 14.273, of December 23, 2021, the Railway Legal Framework.

Two associations advocate for the section, both located north of Lages.
AMPLANORTE is based in Mafra, where the section begins; AMURC is based in Curitibanos, in the middle of the route. AMURES, headquartered in Lages, where the section ends, did not appear in any of the published documents by the deadline. Full system review by Insubornável.

2. What AMURC requested and the extent of their request.

The closest document to the subject of this series is that of AMURC, submitted under the topic of the Economic-Financial Model for the Mercosul Corridor and dedicated entirely to the section between Mafra and Lages. The letter argues that "the temporary absence of commercial operation does not equate to the absence of socio-economic utility or future viability" and makes seven requests: full maintenance of the section in the modeling; protection of the right-of-way, stations, and structures; prohibition of non-compensated return, with explicit ban on removing rails and sleepers; shared use for tourist trains, passengers, and independent operators; progressive restructuring plan; transfer points in Santa Cecília and São Cristóvão do Sul; and cooperation with the Brazilian Army Engineering by Decentralized Execution Term. Two of these requests fill gaps identified in this series: the prohibition of return addresses Clause 3.2.5 of the draft, which allows for the "absence of commercial traffic" as a basis for returning the section, and the military cooperation touches on the theme addressed in the second part, starting from the work of the Superior War School — ESG.

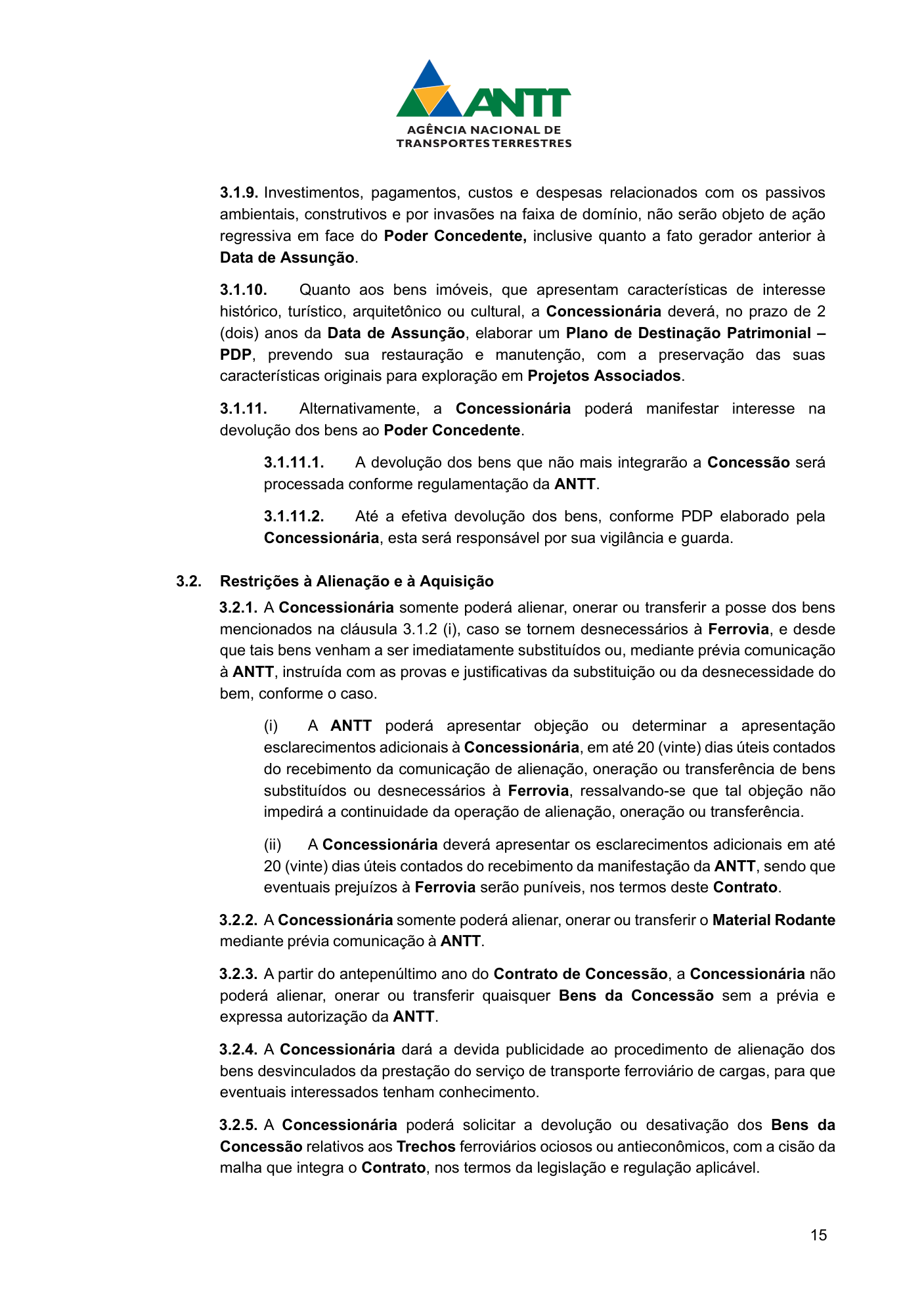

Página 15 da minuta de contrato do Corredor Mercosul, cláusula 3.2.5, sobre devolução ou desativação de trechos ociosos ou antieconômicos
AMURC requests protection against this clause: 3.2.5 allows the concessionaire to request the return of "idle or uneconomical" sections, and "absence of commercial traffic" is sufficient as a criterion.
Reproduction: ANTT — Public Hearing No. 11/2026, official document in public consultation (Bern Article 2(4)); Capture from Insubornável, August 7, 2026.

The scope of the letter, however, is the entity's reach: AMURC represents five municipalities from the Contestado, none of which are mountainous. The final 89 km, from São Cristóvão do Sul to Lages, traverse territory over which it does not speak or request.

No one has submitted a request on behalf of the mountainous tip.
The section has defenders in the north and in the middle, but the last piece of it, which descends to Lages, has no written claim in the process, and it is precisely there that the station, the yard, and the railway battalion are located. This is the Insubornável's reading of the submitted documents.

3. No municipality, city council, or entity from the Mountainous Region has submitted a contribution or attended the sessions.

There is no record of the Municipality of Lages, Correia Pinto, Ponte Alta, Otacílio Costa, São José do Cerrito, or any other municipality from the mountainous trajectory; there is no note from the city council, AMURES manifestation, piece from a federation, union, university, council, or forum based in Lages; and there is no deputy from the region or a mountainous delegation in any of the four in-person sessions in July, which had a total of 665 participants, according to the ANTT's own balance. The statement has the scope of its source: contributions published on ParticipANTT until August 24, 2026, and a manifestation sent through another channel, cabinet negotiation, or unpublished letter would not appear in this reading. In the procedure where ANTT collects subsidies and which it is obligated to respond to, the Catarinense Mountainous Region left no written trail.

4. Why the poorest region requested the least: contributing requires a technical team, the local load is shipped by truck, and the train has been idle for over forty years.

The numbers reflect the scale of what is at stake: Santa Catarina has the third highest Human Development Index (HDI) in the country, and Serra is its poorest region.13,000 families in poverty or extreme povertyAccording to a survey by AMURES itself, and per capita gross domestic productR$50,561 in LagesThe text: "It has a value of R$ 56,314 below the state average. This territory is crossed by 292.76 km of railway built by the Army's railway battalions, an asset that would cost billions to rebuild: just the recovery of the segments affected by the 2024 floods is estimated to exceed R$ 2 billion, according to the ANTT cited in the second part. When the Union opened the only procedure that decides the fate of this heritage for the next thirty years, the region did not appear."

Three reasons explain the absence, and none of them justify it: the first is the cost of participating, which is not like signing a petition, but reading 617 pages and drafting a clause proposal; FIEP and the City Hall of Curitiba attended with their own technical team. However, the cost is not a barrier: AMURC, which states in its own letter "in a region with the lowest HDI in Santa Catarina," submitted ten pages with seven requests.AMURESThere are 18 municipalities, a presidency, a reformed regiment in 2026, and regular assemblies - quite a setup for a two-page job. The second reason is that the mountain economy, based on wood, paper, cellulose, and livestock, has built its logistics around trucks, and those who could claim the rail line didn't have an immediate interest in it. The third is that passenger transport on this sectionIt ended in 1978, and the mixed train in 1983.: An entire generation grew up without seeing a train, and no one claims what they never saw in operation.

Silence has a price set in norm: theANTT Resolution No. 6,058, of December 19, 2024considers the section idle if there is no commercial traffic for two years, and the draft in consultation allows the return of the idle section at the request of the concessionaire, as the second part showed. Without a request in the consultation, there is no obligation in the contract; without an obligation, there is no train; without a train, the section becomes returnable, and the cycle begins again every two years of stopped track.

Where there is a machine and there is a deadline, absence is an order of priority.
Poverty explains the cost of participating; it does not explain the absence. Those who declare in the state's lowest IDH region paid this cost, and the entity that speaks for the Serra has a functioning structure, presidency, and assembly. This report does not know why the Serra did not go, and it does not attribute bad faith to anyone: it records that there was a decision, that it was avoidable, and that the bill goes to the region. This is the Insubornável's reading of the 180 contributions published.

The exit is cheap: a two-page letter signed by the Mayor of Lages, protocolled until 23:59 on September 30, has the same formal weight as the FIEP letter, because the ANTT is obligated to analyze all contributions and publish a report with the full reproduction of them.

Why the Serra endpoint needs its own request

The section is in the Mercosul Corridor: 1,865.78 km with a projected investment between R$ 4.5 billion and R$ 4.8 billion, as per the official document consulted, a divergence addressed in Section 9, of which around R$ 3 billion for the reconstruction of the affected Gaúcho network by the 2024 floods. It's the weakest lot among the three - potential of 5.6 million tons per year, against 32.6 million of the Paraná-Santa Catarina Corridor - and only balances the account with a neighboring concessionaire's cross-subsidy. The natural priority of the lot will be the reconstruction of the 432 km of Gaúcho network, which is legitimate; imprudent is that the prioritization occurs at the expense of the silent deactivation of a Catarinense segment for which no written preservation demand was made.

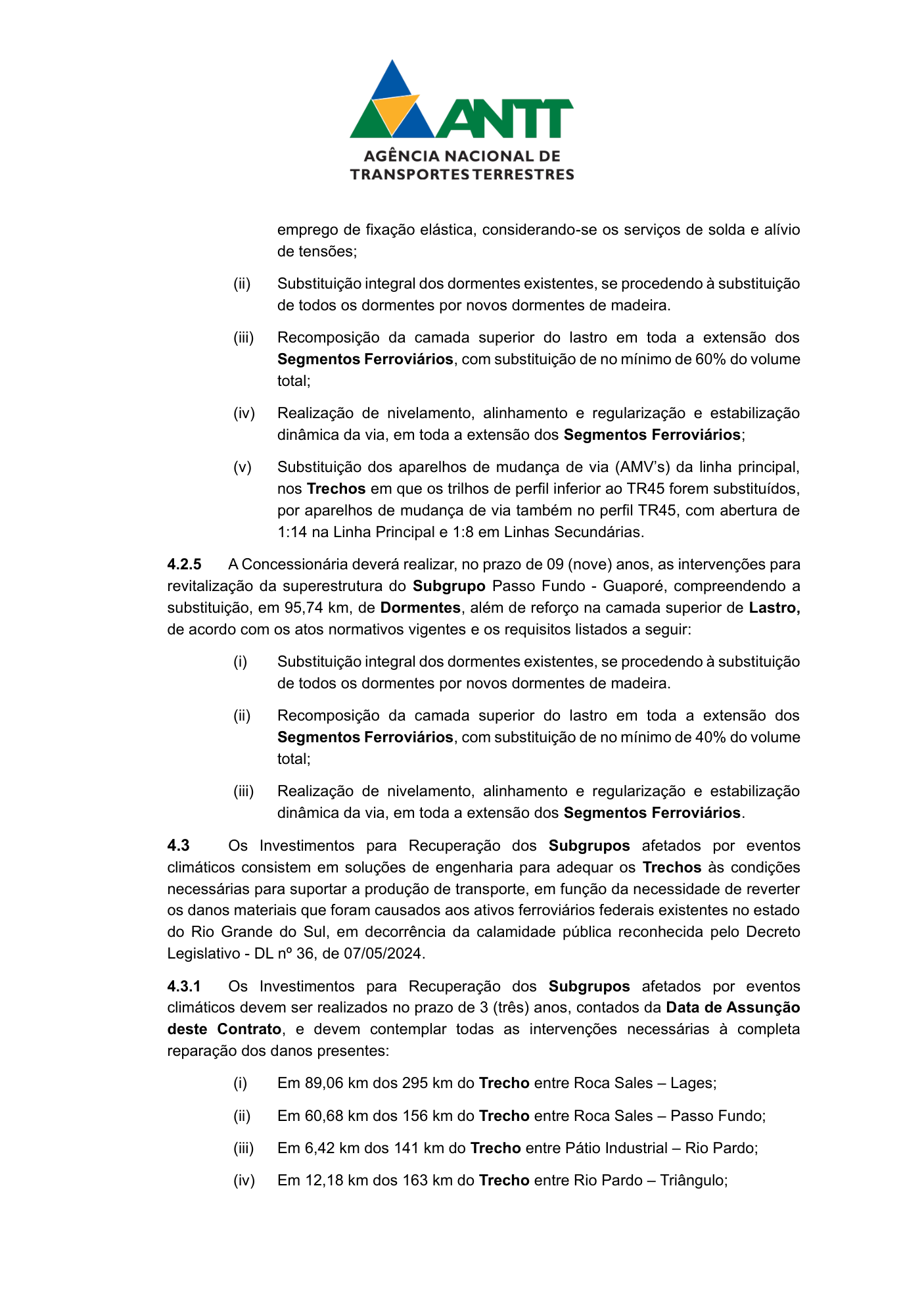

Página 13 do Caderno de Obrigações do Corredor Interestadual, com o item 4.3.1 sobre a recuperação de 89,06 km dos 295 km do trecho Roca Sales – Lages
The annex where the works gain a deadline and cost reaches Lages only through the south: "89.06 km of the 295 km section between Roca Sales - Lages", the Gaúcho endpoint. It's the gap that a Serra request would need to fill.
Reproduction: ANTT - Public Hearing No. 11/2026, official document in public consultation (Bern Article 2(4)); capture from Insubornável, August 7, 2026.

Besides the cargo, two uses already authorized by law continue without a requested clause for the entire axis. Regional passenger transport and Tourism, provided for in the Legal Framework of Railroads, have only partial requests: Northeast associations request a study, but only for the coastal EF-485, and AMURC requests shared use, but only up to São Cristóvão do Sul. The strategic reserve of use by the Union, for defense and mobilization trains, AMURC touches upon by proposing cooperation with the Army, without requesting a reserve clause. None of these uses is included in the draft as an obligation, and the consultation is the only moment when it is possible to request their inclusion.

How to contribute, step by step

Anyone can contribute, free of charge, online, without a lawyer, until 11:59 p.m. on September 30, 2026, in accordance with Article 23 of Resolution ANTT No. 6,020 of July 20, 2023.ANTT Resolution No. 6,020, of July 20, 2023. The door opensThe event at ParticipANTTAnd you log in through the gov.br account — the basic level is sufficient, and document reading does not require registration. City hall, council, or association enters through the account of the representative, with the signed institutional letter attached.

In the "Contribute" section, there are thirty topics, one per document, and contributions are most effective when targeted to the right topic. Note the names: no topic is called "Interstate Corridor," which is how technical files refer to the Mercosul Corridor; on the screen, topics in this batch are "Mercosul Corridor Obligations Notebook," "Mercosul Corridor Contract Draft," and so on. The exact device is specified, a draft is proposed, the justification is written, a PDF is attached, and the protocol proof is saved, which proves that the point was raised before the Agency's decision. Those advocating for the axis between Mafra and Lages also file the request in the three equivalent topics of the Paraná-Santa Catarina Corridor, because the connection to Curitiba crosses both batches starting from Mafra.

Four concrete requests that any city hall, council, or association can formulate
RequestWhere to deploy, and what it solves
Mandatory technical inspectionObligation Book: 180-day deadline from assumption, covering the geometry of the route, superstructure, platform, drainage, bridges, viaducts, tunnels, and level crossings of 292.76 km, with a public report.
Recovery plan with schedule, physical goal, and value.Obligation Book: makes the obligation enforceable ex officio, without relying on subsequent negotiation, as demonstrated by the second party in this series today.
Safeguard against return or deactivation.Contract Draft: prohibits return until the study and the Agency's reasoned decision are completed, and protects stations, yards, switches, and workshops.
Passenger and tourism study along the axis.Contract Draft and Obligation Book: addresses the gap identified in the Demand Study, with a deadline set in the contract.
Citizen contribution is equivalent to federation contribution.
The Agency is obligated to analyze everything it receives and publish a report with the full reproduction of the manifestations, in accordance with Resolution No. 6,020 of 2023. There is no contribution too small to enter the process. Questions about the procedure are addressed by the Public Hearing Commission, at the following address:ap011_2026@antt.gov.br.

7. What comes next, and what remains open?

With the deadline passed, the ANTT will consolidate the comments and forward the process to the TCU: the tender is scheduled for publication in December 2026, the auction of the three lots is planned for the first quarter of 2027, and the current contract ends in February 2027. After sending it to the TCU, any changes will depend on individual negotiations, without the force of a public hearing.

This investigation does not know, until publication, if any Serraan entity is preparing a manifestation, if AMURES deliberated on the matter in a meeting, or if the City Hall of Lages was formally notified of the inquiry; none of this is stated in public documents. Unanswered remain the questions inherited from previous sections: the number of the sanctioning process and the infraction report against the concessionaire, the value and status of the fine, the reports of the scheduled inspections for 2025 on the stretch, and the date of the last commercial circulation between Mafra and Lages.

What each block asked for, and about which part of the line.
ActorRequestReach in the route mapping
AMPLANORTE, with AMUNESC, AMVALI, and CIMUInclusion of EF-485 in regional passenger transport studiesCoastal axis, from São Francisco do Sul to Mafra
AMURCFull maintenance of the section, asset protection, prevention of return, shared use, multimodal poles, and cooperation with the ArmyFrom Mafra to São Cristóvão do Sul, in the Contestado region
AMURES and mountainous municipalitiesNo published contributionSouthern end of the segment, up to Lages
Government of Santa CatarinaCorupá Mountains, Babitonga Bay, state logistics lawCoast and north of the state
Curitiba City Hall and IPPUCCuritiba Railway Ring as mandatory workParaná-Santa Catarina Corridor
MPF, Coordinated Action South MeshMinimum possible number of returns and reuse of infrastructureEntire South Mesh

Anyone who protocols a contribution about the axis between Mafra and Lages can send the protocol number through the pageSuggest a Pautaor by emailnewsroom@insubornavel.comAfter the deadline, Insubornável will publish the balance of what Catarinense Mountain Range brought to the Agency.

What the contract reserves for each section, in reais

The consultation does not only decide who speaks: it decides how much each section of the track receives. The Obligations Book, which is Annex 1 of the contract, includes in Appendix A Table 3, titled "Total Cost Estimate of Determined-Term Investments", and this table lists, section by section and in reais, what the future concessionaire is obligated to do with a set date.

The care with which the modeling was put together can be measured by the first page of the very Obligations Book. Item 1.1 states that this book defines the obligations "of mandatory compliance by the Concessionaire of the 'Paraná - Santa Catarina Railway'". The phrase is correct in one of the three documents and incorrect in the other two, because the same page also opens the Interstate Corridor and the Gaucho Mesh books, which are other concessions, with a different object and contract. The three files diverge from each other in the investment tables and work deadlines, but the page that defines to whom each one applies was copied without correction: the three images on the first page have the same verification code. It's a formal defect, and it doesn't change a comma from what Table 3 determines; it's noted because the ANTT received from the TCU the recommendation to extend the contribution period precisely to perfect these documents, and because the State of Santa Catarina maintains in court that it did not have full access to the studies that support them.

On the Interstate Corridor, where the Serra line is located, the entire table fits on six lines. Four are superstructure works: Roca Sales–General Luz, for R$ 187,734,845.56; Tigre–Cacequi, for R$ 201,824,715.35; Passo Fundo–Guaporé, for R$ 149,471,473.29; and Pátio Industrial–General Luz, for R$ 77,426,712.35. The fifth includes the recovery of the sections affected by the 2024 floods and accounts for R$ 2,279,736,004.84 on its own. The sixth is for locomotives, and instead of a value, it has an asterisk: "Met through leasing, as established in the Contract". The corridor totals R$ 2,896,193,751.39, and almost four-fifths of that money goes towards rebuilding the Gaucho Mesh.

The section between Mafra and Lages does not appear on any of these lines: it doesn't show up with a lower value, a longer deadline, or under another name, and it simply is not on the table. The same goes for the 206.22 km between Lages and Feitor Faé, because the climate event recovery reaches 89.06 km of the 295 km subgroup Roca Sales–Lages, and those 89.06 km correspond to the length of the Feitor Faé–Roca Sales segment, already in Gaucho territory, with no relation to the 89 km between São Cristóvão do Sul and Lages mentioned in Section 2.

It's not a forgotten section, and that's the point: the Engineering Study for the same corridor identifies the line by code INTE_04, assigns it 292.76 km of metric gauge, and decomposes it into twelve segments measured one by one, from Mafra to Itaiópolis, 35.77 km, to Correia Pinto–Lages, 30.27 km. The same study warns, when discussing the impact of not recovering the damaged sections, that the corridor would be "virtually reduced" to three segments, and names Mafra–Lages as one of them. The same study that measured the line segment by segment, cataloged it, and recognized its importance is the one that left it out of the works plan.

Comparing it with the neighboring corridor completes the reasoning: in Table 3 of the Paraná–Santa Catarina Corridor, Mafra appears twice, and both times with money: the Engenheiro Bley–Mafra segment receives R$ 163,686,493.20, and the Mafra–São Francisco do Sul segment R$ 608,179,880.89. Mafra is served, therefore, but as a point of passage for the loads that descend to the Paranaguá and São Francisco do Sul ports. The line that leaves Mafra and climbs the serra towards Lages is the one that receives nothing.

Let's say what these works are, so as not to imagine a new railway. The book describes renovation: standardization of the track to the TR57 profile, in long-sold track with elastic fixation; complete replacement of the sleepers by new wooden sleepers; recomposition of the upper layer of the ballast, between 40% and 80% of the volume according to the section; leveling, alignment, and dynamic stabilization of the track; and replacement of the points apparatus. It's the heavy maintenance a line receives when it is intended to be used.

The size of the cake also deserves examination, as the global figure impresses at first sight but shrinks on closer inspection. The R$ 14.4 billion projected for the entire South Mesh, divided by the 4,248.45 km of the new concession, amounts to R$ 3.39 million per kilometer, or approximately US$ 659,000 at the August 2026 exchange rate. In Argentina, the renewal of 1,593 km of the Belgrano Cargas line, a narrow-gauge railway like ours, is budgeted at US$ 2.9 billion, which is US$ 1.82 million per kilometer, almost triple the amount. The World Bank, in a study on the poor railways of sub-Saharan Africa, estimates at least US$ 350,000 per kilometer, at 2008 prices, to rebuild existing lines with new materials, a value that, corrected for American inflation, is close to what ANTT projects. Brazil's plan is not generous: it remains at the bottom of what the world spends to recover old railways.

Even within the consultation, some contest this bottom limit: Davi Barreto, President of ANTF, argued in the Brasília session that the modeling understates recurring investments and does not provide for adequate rolling stock, and that the locomotive leasing adopted in the tender "does not exist in Brazil and is not a reality of the Brazilian industry." The Superintendent of Railway Projects at Infra S.A., Diógenes Alvares, responded that "it is not a deterministic study" and that there is room to reassess both the operational cost and the investment. If costs increase upon revision, the surplus of the Paraná-Santa Catarina Corridor, which is the source of the promised R$ 4.93 billion in cross-investments for the two deficit corridors, will shrink, and the segment that already entered without any funding will become the last in a shorter queue.

9. The shrunk design and the money already owned

Before the contract and before the table, the kilometer account had already changed. The concession ending in 2027 covers 7,223.4 km, as per the ANTT page on the Rumo Malha Sul contract; the one under consultation covers 4,248.45 km, summed across the three corridors, as per the College Directorate's communication of June 2, 2026. Subtracting these two official figures yields 2,974.95 km, or 41.2% of the currently granted extension, excluding the corridors going to auction—this calculation's figure, not disclosed by the Agency. The communication also does not state what will happen to this difference: it makes no mention of return, deactivation, a new tender, or any other disposition. The question is not from the Unyielding: in a circular letter of February 27, 2026, seven members of the MPF already noted that the report by the Ministry of Transport's working group suggested returning extensive segments, "based on another study by the Ministry that has not yet been made public to society."

Here, the precision that changes the reading of the Catarinense case: the 292.76 km between Mafra and Lages are not among the excluded kilometers, because the Mercosul Corridor restarts precisely in Mafra, according to the description in the same communication. The segment entered the perimeter, and that's why Table 3 from the previous section is important: for what was left out, the exit was already made in the design; for what entered without marked works, the exit will be available later, through a request for return due to idleness allowed by clause 3.2.5, as the second part of this series showed.

The money follows the same design as the route, and the communication breaks down the R$ 4.93 billion in cross-investments mentioned in the previous section as follows: the Paraná-Santa Catarina Corridor, which handles 78% of the Malha Sul's cargo, transfers R$ 1.47 billion to the Rio Grande Corridor and R$ 3.46 billion to the Mercosul Corridor, an arrangement that, in the document's words, ensures the viability of the ensemble "without relying on direct contributions from the Treasury as the primary source." How much the corridor receiving the largest transfer costs is a point where two documents from the same Agency diverge: the official project page attributes R$ 4.5 billion to it, while the communication speaks of R$ 4.8 billion. Using either figure, and deducting the approximately R$ 3 billion already allocated to the reconstruction in Rio Grande, there are between R$ 1.5 billion and R$ 1.8 billion left for the entire remainder of the 1,865.78 km of the corridor, which starts in Iperó, São Paulo, and crosses Paraná and Santa Catarina before reaching Rio Grande do Sul. The subtraction is from this calculation; the divergence between the figures is from the official documents.

There is a second, less cited but more eloquent number: the table below shows CAPEX (the investment money, what is spent once to build, rehabilitate the track, and buy equipment) and OPEX (the current expense of operating and maintaining the railway, year after year), and it is the OPEX, projected over thirty years of concession, that matters here. Dividing each corridor's figure by its length and by thirty years, the annual expense per kilometer is R$ 605,754 in Paraná-Santa Catarina, R$ 238,555 in Rio Grande, and R$ 87,542 in Mercosul: 6.9 times less, per kilometer, in the corridor where Lages' line is, compared to the structuring corridor. The division is from this calculation based on the published values. Low operational expense per kilometer is, as a rule, a projection of a sparsely used train; however, the Unyielding did not have access to the calculation memory, and the explanation may lie in the economic-financial model submitted to the consultation, which has not yet been read by this calculation.

What ANTT projects for each corridor, and the cost per kilometer
Corredor - CorridorExtensão - ExtensionCarga - LoadCAPEX - Capital ExpenditureOPEX - Operational ExpenditureOPEX por km ao ano - OPEX per km per year
Paraná–Santa Catarina - Paraná-Santa Catarina1.502,26 km - 1,502.26 km78%R$ 6.9 billionR$ 27.3 billionR$ 605,754
Rio Grande880.3 km16,6%R$ 3.0 billionR$ 6.3 billionR$ 238,555
Mercosul (Inter-state)1,865.78 kmundisclosedR$ 4.5 biR$ 4.9 biR$ 87,542

The final piece of this series arrives at a point where the second part reached through another route: work not foreseen in the Obligations Book, of medium or large volume, depends on a common agreement with the concessionaire. Recollecting almost three hundred kilometers in operation would be work to negotiate within the corridor whose investment budget is already committed, in most part, to another state. The project page discloses an internal return rate of 14.08%, without detailing the assumptions or breaking it down by corridor. The Catarinense section does not appear in this calculation with a specific name, for the same reason it does not appear in the draft: in both documents, it falls within the scope of the concession, without any line naming it.

10. To explore: the sources, with notes

10.1 The previous parts of this series

10.2 The public consultation documents

10.3 The indicators of Serra Catarinense

10.4 The entities that defend the segment
